INTERNAL CONTROL OVER FINANCIAL REPORTING (ICFR) – THE COSO WAY.

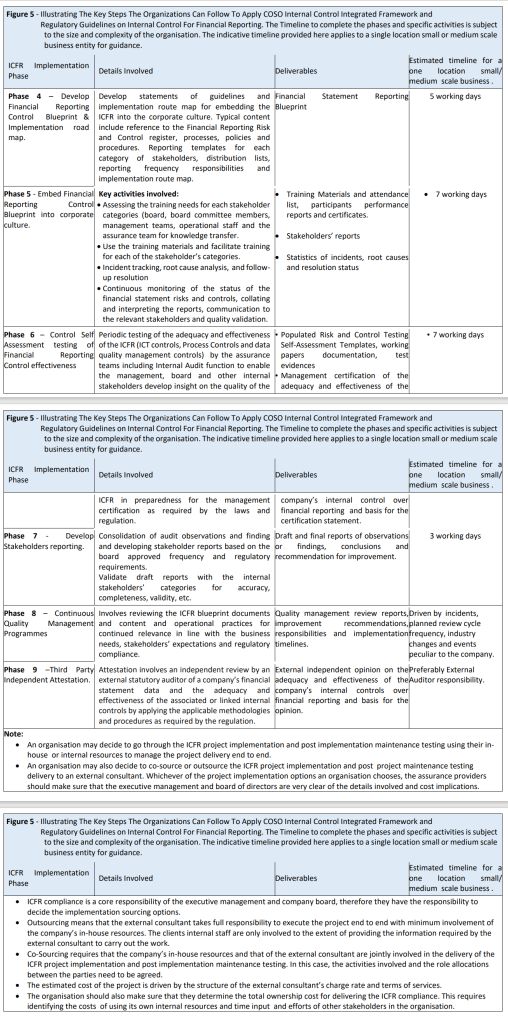

It is important to note that some of the activity phases above can be collapsed or merged into one, for example, Phase 1 –Project Preparatory Training and Phase 2- Project Planning may be grouped under one. Similarly, Phase 3 –   Conduct Risk Control Mapping on Key Financial Accounts and Phase 4 – Develop Financial Reporting Control Blueprint & Implementation Road map may be merged as one phase.

Sally OgwoOkey-Umahi

Sally OgwoOkey-Umahi

Corporate Governance Professional, Board Advisor, and Executive Consultant specializing in enterprise risk management, regulatory compliance, and institutional leadership.

Learn More About Sally →
